Lead Time & Capacity
We are equipped to scale production quickly, supporting projects from concept development to mass manufacturing.
Scalable Production Capacity
VERTICAL INTEGRATION
At full operating capacity, our manufacturing facilities can produce between 2 million to 3 million pieces per month across plastic and metal categories. This high-volume capacity allows us to fulfill bulk orders, staggered shipments, and phased product rollouts, all while maintaining quality and consistency.
180-Day OEM Project Timeline

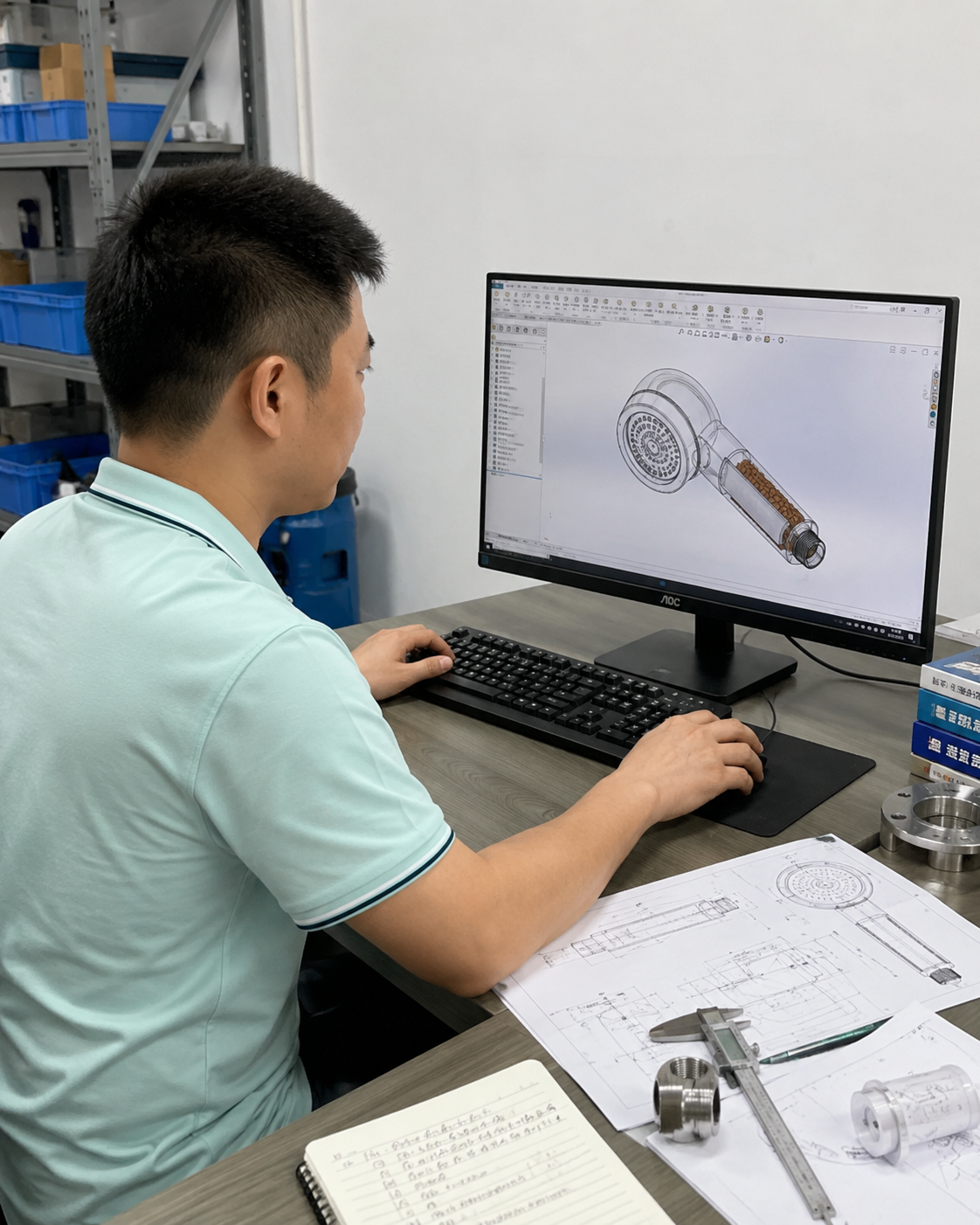

3D Modeling & Engineering Design
3D Modeling & Engineering Design
Duration: 2 weeks
Our team creates detailed 3D models and mechanical drawings to validate structure, function, and feasibility before prototyping. Includes DFM (Design for Manufacturing) input.
Duration: 2 weeks
Our team creates detailed 3D models and mechanical drawings to validate structure, function, and feasibility before prototyping. Includes DFM (Design for Manufacturing) input.
Functional Prototype
Functional Prototype
Duration: 7–10 working days (after final design)
We create a working prototype to test function, appearance, and assembly fit. This step helps reduce revisions during mold development.
Duration: 7–10 working days (after final design)
We create a working prototype to test function, appearance, and assembly fit. This step helps reduce revisions during mold development.

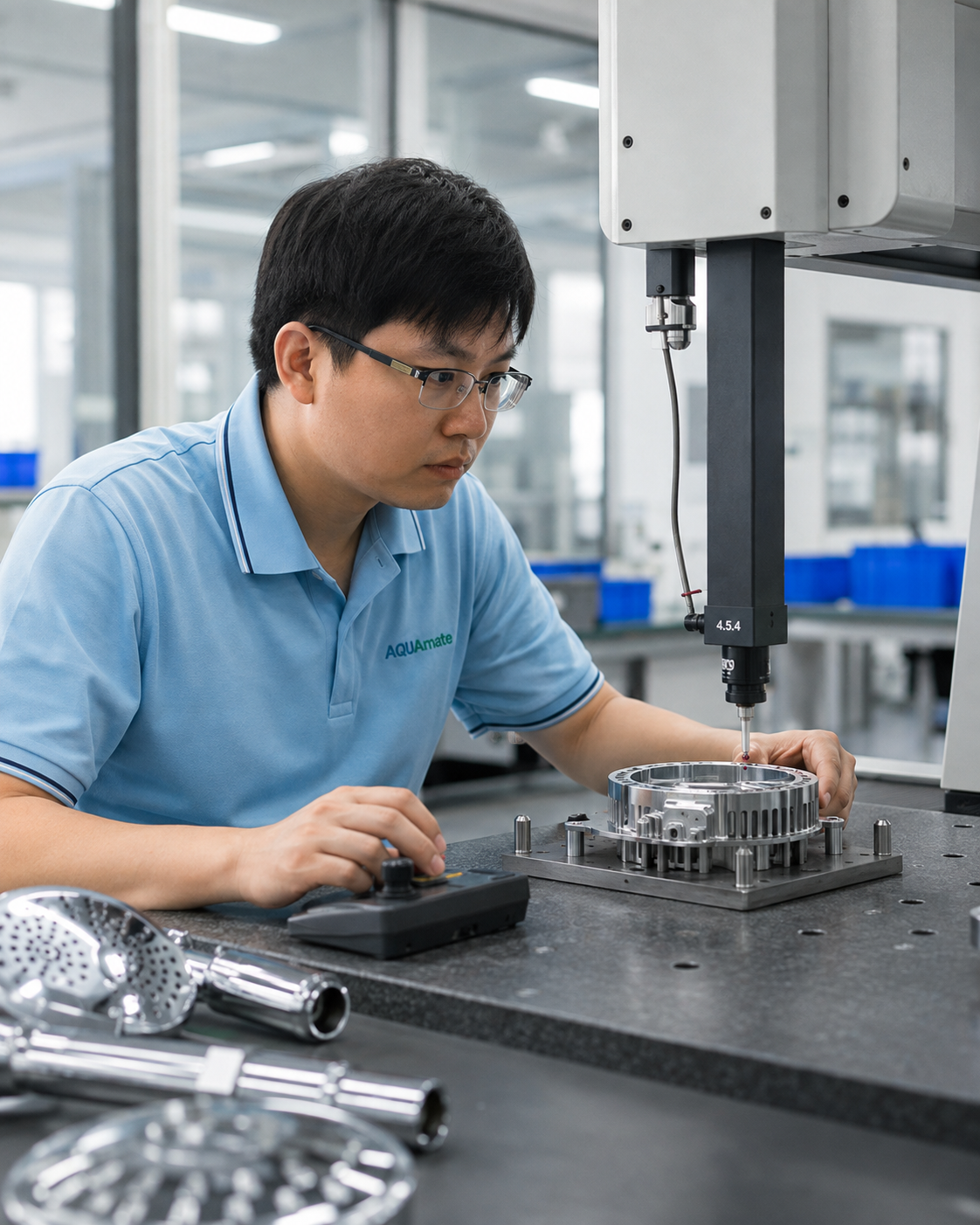

Mold Fabrication
Mold Fabrication
Duration: 45–60 days
Production tooling is built once the prototype is approved. Each mold is engineered for long-term use and can produce up to 500,000 pieces. Tooling is optimized for durability and part accuracy.
Duration: 45–60 days
Production tooling is built once the prototype is approved. Each mold is engineered for long-term use and can produce up to 500,000 pieces. Tooling is optimized for durability and part accuracy.

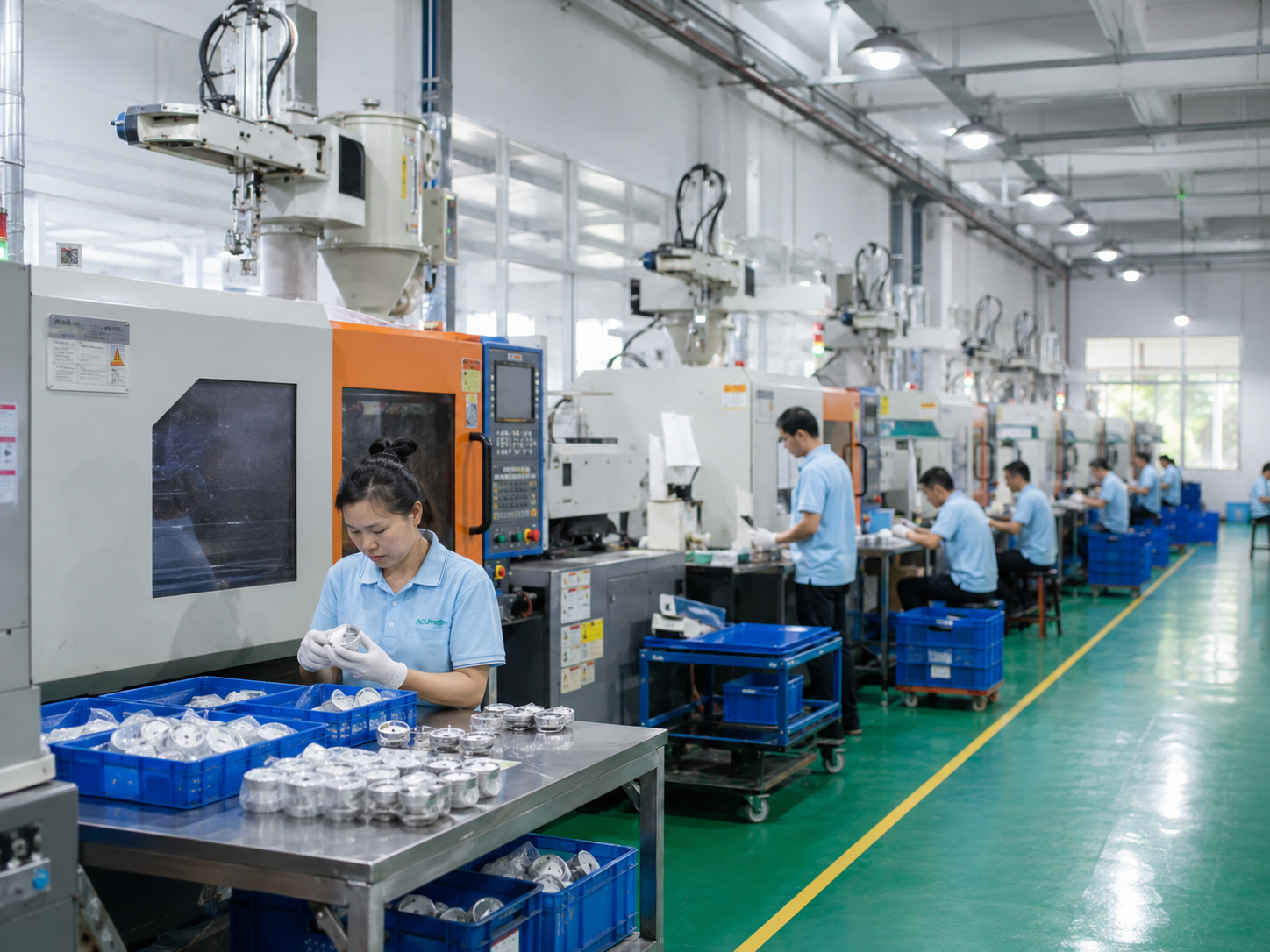

Injection Molding
Injection Molding
Duration: Varies by complexity and quantity
Once the mold is complete, we move into injection molding. We adjust machine scheduling and cycle times based on material, part size, and finish requirements.
Duration: Varies by complexity and quantity
Once the mold is complete, we move into injection molding. We adjust machine scheduling and cycle times based on material, part size, and finish requirements.
Trial 1 (T1) – Sample Run
Duration: 7–10 days
We conduct a small production run of approximately 100 pcs to test mold performance and part consistency. Once T1 is approved, packaging specifications are confirmed and locked in.
Trial 1 (T1) – Sample Run
Duration: 7–10 days
We conduct a small production run of approximately 100 pcs to test mold performance and part consistency. Once T1 is approved, packaging specifications are confirmed and locked in.
Mass Production
Mass Production
Plastic Parts Duration: 40-45 days
Metal Parts Duration: 60-65 days
Final production lead times begin after T1 approval and packaging confirmation. These timeframes include material procurement, molding, surface finishes, assembly (if applicable), and final packaging.
Plastic Parts Duration: 40-45 days
Metal Parts Duration: 60-65 days
Final production lead times begin after T1 approval and packaging confirmation. These timeframes include material procurement, molding, surface finishes, assembly (if applicable), and final packaging.
Need a lead time estimate for your project?
Contact us and we’ll prepare a detailed timeline based on your product specs and volume.
